How Long Does It Take To Erect A Steel Building

Blogs 2680

Generally speaking, a professional team of four people can complete the steel skeleton of a standard 5,000 square foot commercial building, which takes about 5 to 7 days. In the case of a large industrial plant of 10,000 to 50,000 square feet, the installation cycle is usually extended to 3 to 6 weeks-of course, this depends on the complexity of the structure and the lack of on-site equipment.

However, when planning, it is important to distinguish between “installation time” (just columns and planks) and the entire project cycle. If you include the design, processing, transportation and foundation maintenance time, the actual cycle is usually 12 to 16 weeks from signing the contract to being able to use it.

Teardown By Size: Small Vs. Large Facilities

The physical assembly time of a steel structure building depends to a large extent on the area and the complexity of the design. There is a big difference between the two.

Standard Commercial Building (5,000 Square Feet)

For a standard 5,000 square foot commercial structure, speed is an absolute advantage. A focused four-person skilled team can complete the installation of the steel skeleton in just 5 to 7 days.

Photos of steel structure commercial buildings

The reason why it can be so fast is that these standard commercial designs usually use prefabricated components, and the on-site splicing is very smooth, and almost no on-site rectification is required. This stage includes erecting the main frame and installing the wall and roof panels.

Industrial Facilities (10,000 – 50,000 Square Feet)

Once the occupied area becomes larger, the construction period will naturally follow. For large industrial projects of 10,000 to 50,000 square feet, the installation window is extended to 3 to 6 weeks. I have a few ideas to explain why there is so much more time:

  • Structural complexity: The larger the span, the heavier the steel used and the more complex the support system.
  • Equipment availability: Lifting heavy beams requires specific heavy equipment (such as large cranes and telescopic fork trucks), and dispatching these equipment on such a large site will itself affect speed.
  • Team coordination: it is 4 enough to do small projects, but large projects often require the cooperation of multiple teams or special subcontracting teams, which increases the difficulty of logistics management.

Steel Structure Workshop


Steel Structure Workshops offer versatile designs. Clear Span ensures unobstructed space, while Centre and Intermediate Columns provide economical solutions for wide spans.

Bridge/Steel Structure Bridgeipsum


Steel Structure Bridges utilize high strength-to-weight ratios to achieve long spans where intermediate supports are difficult.Their versatility makes them essential for critical infrastructure connectivity.

Steel Structure Buildings


Steel Structure Buildings feature versatile designs to meet diverse needs. Clear Span offers open space, while Centre and Intermediate Columns increase economy for large spans. Multi Gable accommodates complex widths.

Installation Time Vs. Total Project Cycle Time

In the steel structure industry, the most common misunderstanding I have ever seen is to regard the time spent on the construction site as the actual duration of the project.

Strictly speaking, the installation time is only the days when the team assembles the frame and planking on site. As I said just now, this may be as short as a week and as long as a month and a half. However, the total project cycle is a realistic timeline from the moment the contract is signed until the building can be put into use. This 1 perspective covers the “behind the scenes” work that must be done before the first beam is lifted.

12-to 16-week Timeline

To achieve the realistic duration of 12 to 16 weeks mentioned at the beginning, the project must go through several key pre-construction stages. These stages, whether parallel or serial, have only one purpose: to ensure that once the installation team enters the site, it will not face any embarrassment of downtime and waiting for materials.

Engineering Design And Detail Drawing Deepening

After the contract 1 is signed, the engineer must immediately produce the structural drawing and anchor bolt arrangement drawing. This is to ensure that the building complies with local codes and load requirements-this is not only a technical step, but also a legal guarantee.

Component Processing

Once the design drawings are approved, production of the steel components begins. Cutting, welding, drilling, all processes must be accurate to the millimeter. Although the processing schedule fluctuates, it usually takes up the majority of the time throughout the delivery cycle.

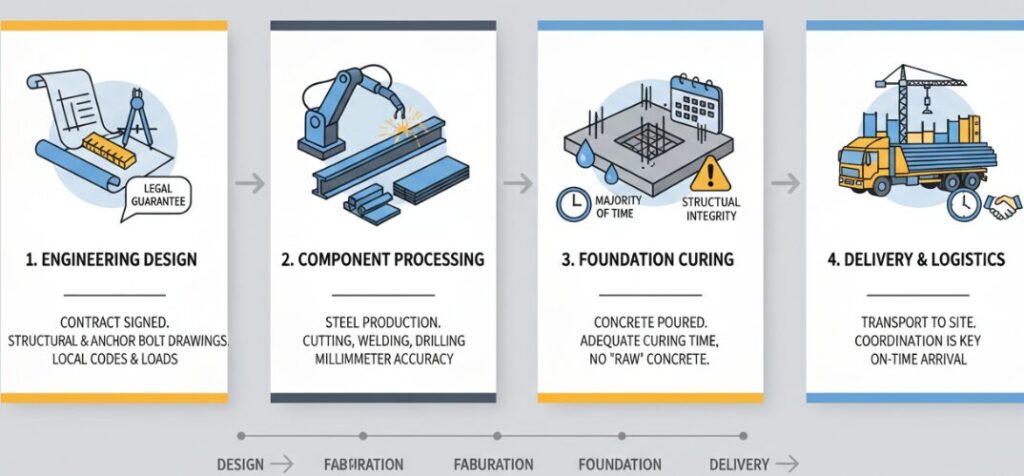

Steel structure building construction process

Foundation Maintenance

In the steel processing at the same time, the scene is not idle. Concrete foundations must be placed and adequately cured. Trying to install steel structures on “raw” (uncured) concrete is an absolute taboo and will directly destroy structural integrity. The curing time must be calculated in the schedule so that it can be seamlessly connected with the steel entry time.

Delivery And Logistics

The final step before installation is to transport the package to the site. The key here is coordination; the steel must arrive on time at the point where the foundation is ready and the installation team is scheduled.

By understanding that the installation period of 5-7 days or 3-6 weeks is only one part of the entire 12-16 week process, project managers can set accurate expectations to ensure that the road from contract signing to completion is smooth.

Author: Michael Turner

“Hi, I’m a Senior Project Manager specializing in pre-engineered steel construction. With over 14 years of on-site experience, I focus on helping clients navigate the complex logistics of industrial builds. I hope is to bridge the gap between rapid erection phases and realistic total project schedules, ensuring your facility is ready for business on time.”
